Project Cost

Tent Structure Breakdown
Item Quantity Cost
Metal Door 1 $3,620
Metal Double Doors 3 $16,188
Automated Roll-Up Sidewalls 2 $19,570
Automatic Garage Doors 4 $24,260
Tents End Kits 2 $42,678
Tent Beams & Fabric $168,114
Building Installation $92,134
Freight $3,005
Total Tent Structure Cost $369,569



Overall Project Breakdown
Item Original Projected Cost New Adjusted Cost
Tent Structure $369,569 $369,569
Fire Suppression System Not Budgeted $150,000
Concrete Work $40,000 Awaiting updated quote
Electrical Work $15,000 Awaiting updated quote
Landscape Work $10,000 Awaiting updated quote
Equipment Upgrades $20,000 $350,000
General Operating Costs $50,000 $50,000
Other Construction Costs Not Budgeted Awaiting updated quote
Total Project Cost $500,000 $919,569

Raising the Tent is not a one time project to save for, we need to continue to save money to Raise the Tent for many years to come!

Renderings

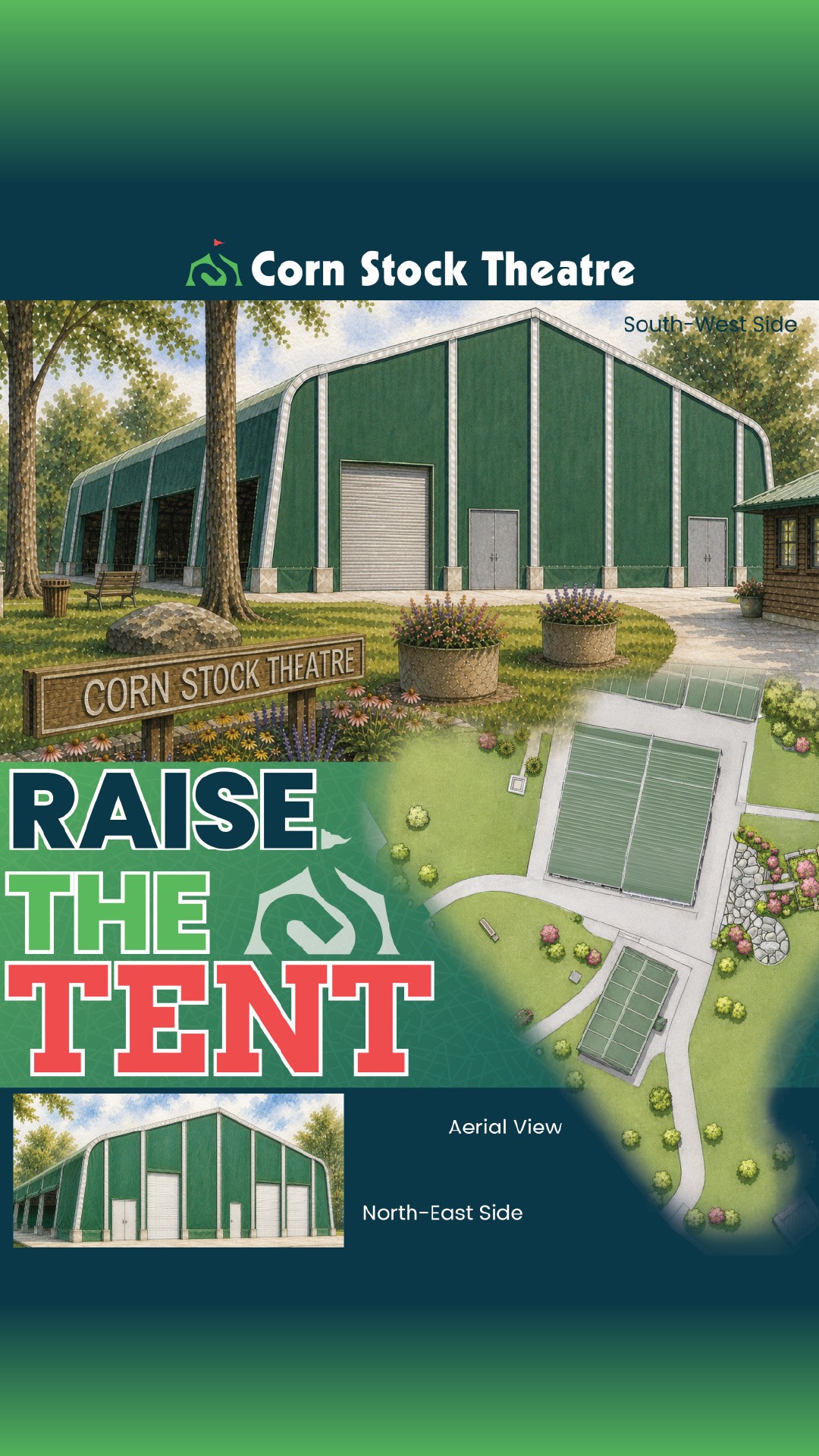

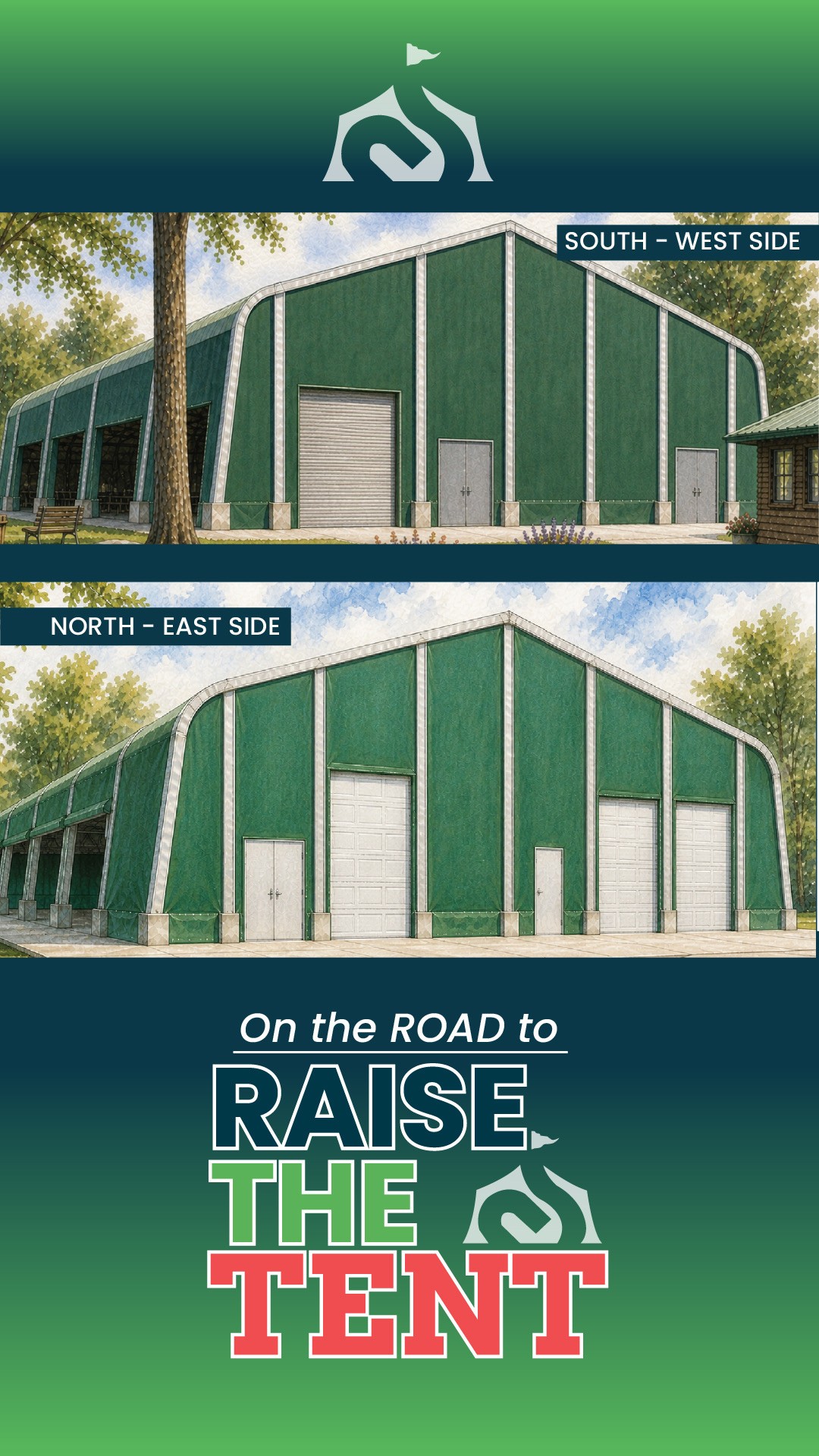

Curious what the new tent will look like? Here is a rendering of what the new tent will look like. Unlike our previous structures, the tent will stay up year-round. This is a 50-year frame (as opposed to a 25-year frame that we have had before).

This tent also requires concrete footings to go into the ground before the tent can even go up. Which means this is a major construction project. Once we have our permits from the city, we can then begin the below steps to Raise the Tent once again.

Project Timeline - Where We've Been

2024
  • August 19, 2024

    First Meeting of New Tent Committee

    The first meeting was held to determine the needs for the New Tent

  • September 25, 2024

    Board Approval

    Corn Stock Board of Directors approves to install a permanent tent structure with ClearSpan.

  • November 20, 2024

    First Deposit Paid

    50% Deposit made to ClearSpan.

TODAY

Project Timeline - Where We're Going

*ALL FUTURE DATES ARE PROJECTED AND SUBJECT TO CHANGE DURING THE CONSTRUCTION PROCESS

2026
  • 3-5 Weeks September 28, 2026

    Tent Construction

    ClearSpan will deliver the manufactured tent and install it on the Corn Stock grounds.

  • 2-4 Weeks October 26, 2026

    Fire Suppression & Electrical Install

    Fire suppression system and electrical installed inside the tent.

  • 2-4 Weeks November 2, 2026

    Occupancy Approval & Inspection

    Fire Marshall and other city officials inspect the work and grant occupancy to the structure.

September 28, 2026October 26, 2026November 2, 2026
PROJECT COMPLETION
